← Industry Perspectives  |  Home

An Act of God, With Letterhead

Author: Julien Simon

Date: September 28, 2026 · 16 min read

Source: https://www.airealist.ai/p/an-act-of-god-with-letterhead

Figure 1 from An Act of God, With Letterhead

On September 24th, 2026, Bloomberg reported that Oracle had sent a force majeure notice to Stack Infrastructure, the Blue Owl company building Project Jupiter, a 2.45-gigawatt Stargate campus in the New Mexico desert [1]. Reuters had its own source and the same reason: “potential delays in securing power for the project” [1]. Force majeure is the clause companies invoke, in Reuters’s words, when “problems arise beyond their control”: war, flood, the occasional act of God. I read Oracle’s filings from this summer. Power was in the risk factors.

Oracle told CNBC: “Project Jupiter remains on our planned schedule.” Blue Owl told CNBC: “This notice does not change the financial commitments to this multi-year project” [1]. So a notice nobody will describe, about a delay nobody admits, changes nothing. Officially.

God, in chronological order

OnMarch 20th, New Mexico’s land commissioner refused to let the campus’s gas pipeline cross state trust land [2]. OnApril 13th, federal staff protested the pipeline because Transwestern, its builder, had not filed a historic-preservation finding [2]. OnApril 27th, Oracle announced fuel cells for Jupiter and wrote that “construction continues to move forward on schedule”, adding that “Oracle will continue to bear all energy costs for Project Jupiter” [3]. OnJune 22nd, its annual report told investors: “We have faced, and may continue to face, challenges with securing reliable and cost-effective power sources” [4]. OnJuly 14th, the commissioner said no again: “Advancing the massive use of gas for a project of this scale is simply not in the best interest of the trust” [2]. The finding had not been filed by the deadline, and onJuly 24ththe federal regulator took the pipeline off its fast track, with other agencies’ decisions under federal authority due by December 3rd [2]. OnSeptember 10th, asked about potential delays in New Mexico and Wisconsin, Oracle’s co-chief executive Clay Magouyrk said that a plan relying on “100% achievement of every one of their deliverables” is “called a bad plan”, and that the data center was “definitely on track” [5].Two weeks later: force majeure.

A government saying no is the kind of event many force majeure clauses list, and nobody outside the deal has read this one. But Reuters’s source adds a detail: “securing power for the site is Oracle’s responsibility under the contract” [6]. If the event is the land office’s refusal, which no one has confirmed, then the act of God is a letter from a land commissioner about a job that the contract reportedly gives to Oracle, a risk Oracle disclosed in its annual report. God, it turns out, has letterhead.

What the notice buys

According to the same Reuters source, Blue Owl has about $3 billion of equity in Jupiter, earns 9% on it while the campus is being built and expects about 11% once it is finished, and force majeure “extends the period during which it pays Blue Owl the lower development-stage rent” [6]. Oracle, by the same account, is responsible for the debt costs and “cannot terminate the lease under any circumstances” [6]. The two points of yield on Blue Owl’s equity come to about $60 million, deferred rather than lost, for each year of delay, or less than five hours of what Oracle spent on capex last quarter [6][7]. The act of God comes with a payment plan.

If you lend to data centers, look at the $288 billion in Oracle leases that have not yet started, “generally expected to commence between the second quarter of fiscal 2027 and fiscal 2029 and for terms of fifteen to nineteen years” [7]. Nobody outside those deals has read their clauses. The notice shows how this tenant reads one. Two questions for the next lease: does the clause exclude risks the tenant has already disclosed, and who carries the power obligation?

We said so, mostly

In “Cloud vs. Clout” we wrote that “Oracle is shifting capital risk to its counterparties” [8]. In “Welcome to Hotel Abilene” we argued that nobody in the Stargate web could check out. We had the direction wrong: the tenant is the one invoking the clause, and the landlord is the one waiting. In May, “The $500 Billion Umbrella” set a test for any Stargate deal: “a site under construction, a power purchase agreement in force, and a builder whose balance sheet can finish the job. Anything less is a press release” [8]. Jupiter has the site. Its power has a fuel-cell announcement from April 27th and a gas line the state refused and then refused to reconsider.

On February 1st, Oracle said it did “not expect to issue additional bonds during calendar year 2026”, a plan that “reflects Oracle’s commitment to maintaining an investment-grade rating” [9]. The same document put about half the money into equity, and Oracle delivered $5 billion in mandatory convertible preferred that week and $19.9 billion in stock over the summer [10]. S&P cut it to BBB-, one notch above junk, on July 9th [11]. The plan was kept. So was the investment-grade rating, by one notch.

The bill comes back

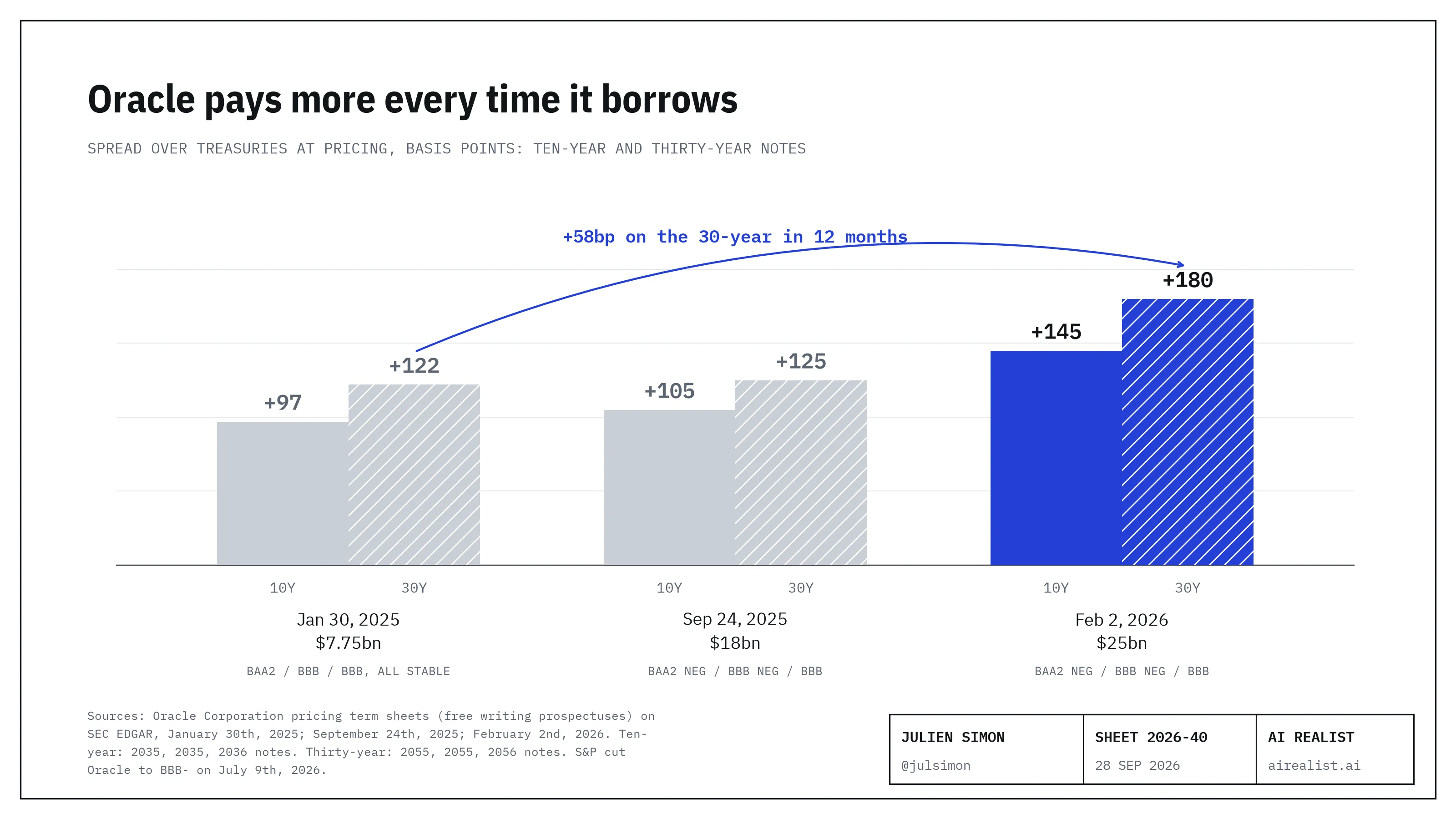

Oracle’s pricing sheets show what it paid over Treasuries at each bond sale since January 2025 [9]:

Figure 2 from An Act of God, With Letterhead

Ten-year: 97 basis points to 145. Thirty-year: 122 to 180. That last bond, the 2056 note, has not held up: on September 28th, Bloomberg data reported by ZeroHedge showed it at 82.4 cents on the dollar and 273 basis points over Treasuries, compared with 180 at pricing [12]. Oracle’s five-year protection cost about 200 basis points in late July, compared with about 93 for Meta and about 53 for the investment-grade index [13], and reached a record of about 227 in the week of the notice [13]. In fairness, that was when the ten-year Treasury yield hit a 19-year high, and every hyperscaler’s spreads widened [13]. Oracle just widened from a higher floor.

Has anyone climbed out of a spread like this? Boeing, whose default swaps hit 488 basis points in March 2020, a price Bloomberg read as 31% odds of default within five years, is still rated investment grade by all three agencies [14]. Others did not: Enron was downgraded to junk status four days before it filed for bankruptcy, and Lehman remained in the A category until it failed [14]. Oracle’s exposure is in its filings. My read: that is the kind of problem a company pays for rather than dies of, and the payment is the chart above.

S&P already adds Oracle’s $260 billion of lease commitments to the debt in its forecast, puts leverage “in the mid-4x area in fiscal 2027”, and says it could cut again if it expects Oracle “to sustain leverage exceeding 4.5x” [11]. The forecast sits at the edge of the trigger.

Oracle’s own annual report says a downgrade could “affect the terms or availability of certain long-term commitments (including data center leases)” [15]. One more S&P notch would not, by itself, push Oracle’s bonds out of the main index, which uses the middle of three ratings: Moody’s (Baa2, negative) and Fitch (BBB) each sat two notches above junk at Oracle’s last bond sale [16].

But every notch raises the price of the next dollar, and Oracle needs a lot of dollars, as do landlords like Jupiter’s, who borrow against its name. The Financial Times reports Jupiter’s loans quoted at 89 to 91 cents on the dollar [17]. At those prices, the roughly $18 billion banks reportedly lent would be marked $1.6 billion to $2 billion below par, by my calculation [17].

So the notice moves risk. A few tens of millions a year of it is deferred on Blue Owl’s equity. The rest, over time, lands on Oracle’s credit: Oracle will pay for it in new-issue spreads when it next borrows, and whoever lends to it bears the risk.

Oracle’s case

Michael Egbert, an Oracle vice president, wrote to The Santa Fe New Mexican that “force-majeure notices are commonplace in developments of this scale and are often used to preserve contractual rights among project partners,” and that they “do not, by themselves, establish a project delay or change delivery expectations” [18]. That is true of many notices: a tenant facing a permit fight it does not control is doing what counsel advises. And no, Larry Ellison’s pledged shares are a separate matter: Oracle’s proxy says those loans fund only “outside personal business ventures” [19].

What would prove me wrong

Two dates and a sentence, all public. New Mexico’s decision on the fuel-cell air permit, due by November 23rd; other agencies’ pipeline decisions under federal authority, due by December 3rd [2]; and Oracle or Blue Owl saying on the record that Jupiter’s lease has started on time. If all three go Jupiter’s way, the notice was mostly paperwork, and I will say so.

Until then, the act of God has a letterhead and a docket number: CP26-80.
